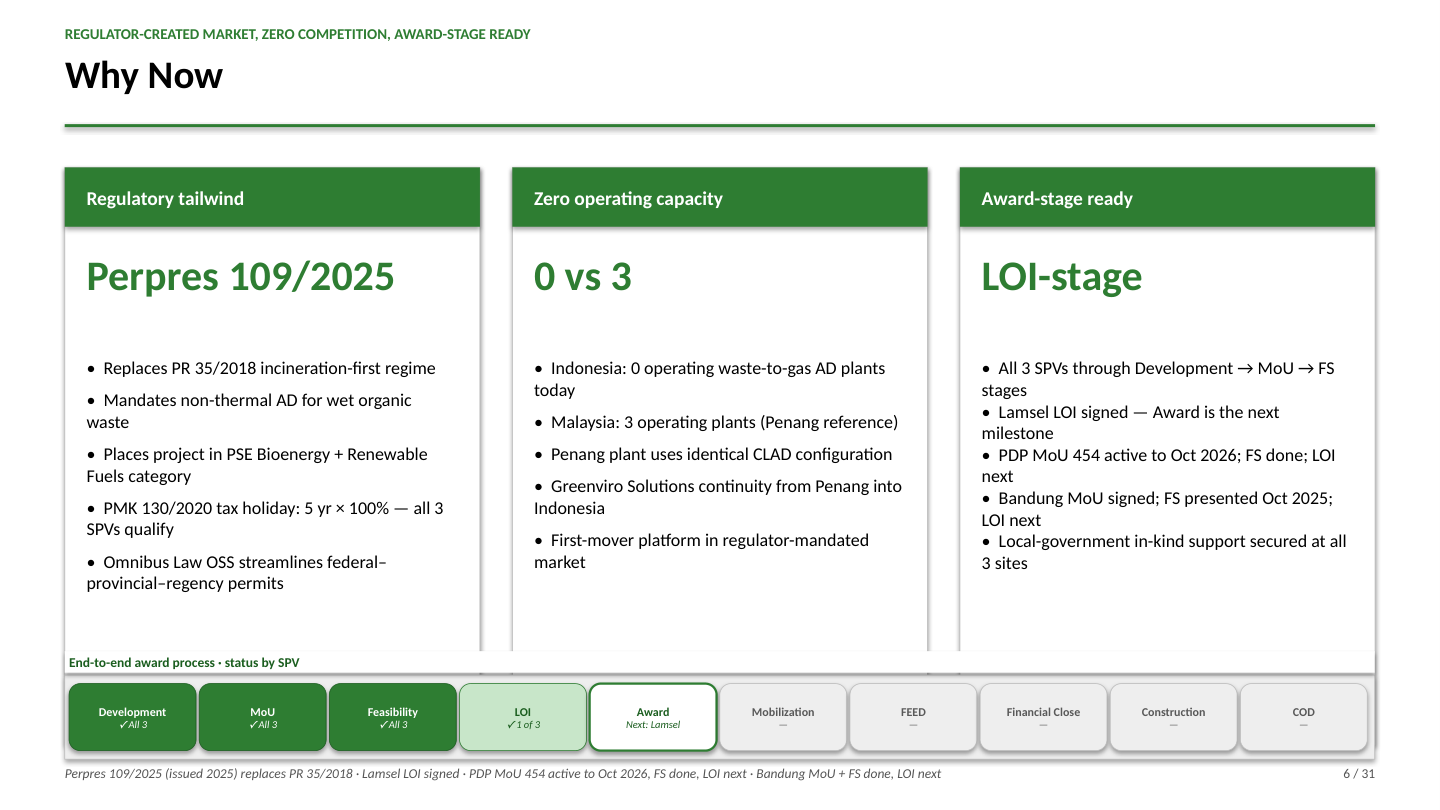

Perpres 109/2025
Regulatory tailwind
Zero operating capacity
Award-stage ready
0 vs 3
LOI-stage
• Replaces PR 35/2018 incineration-first regime
• Mandates non-thermal AD for wet organic waste
• Places project in PSE Bioenergy + Renewable Fuels category
• PMK 130/2020 tax holiday: 5 yr × 100% — all 3 SPVs qualify
• Omnibus Law OSS streamlines federal–provincial–regency permits
• Indonesia: 0 operating waste-to-gas AD plants today
• Malaysia: 3 operating plants (Penang reference)
• Penang plant uses identical CLAD configuration
• Greenviro Solutions continuity from Penang into Indonesia
• First-mover platform in regulator-mandated market
• All 3 SPVs through Development → MoU → FS stages
• Lamsel LOI signed — Award is the next milestone
• PDP MoU 454 active to Oct 2026; FS done; LOI next
• Bandung MoU signed; FS presented Oct 2025; LOI next
• Local-government in-kind support secured at all 3 sites
End-to-end award process · status by SPV
Development
✓ All 3
MoU
✓ All 3
Feasibility
✓ All 3
LOI
✓ 1 of 3
Award
Next: Lamsel
Mobilization
—
FEED
—
Financial Close
—
Construction
—
COD
—
